Background
Vision

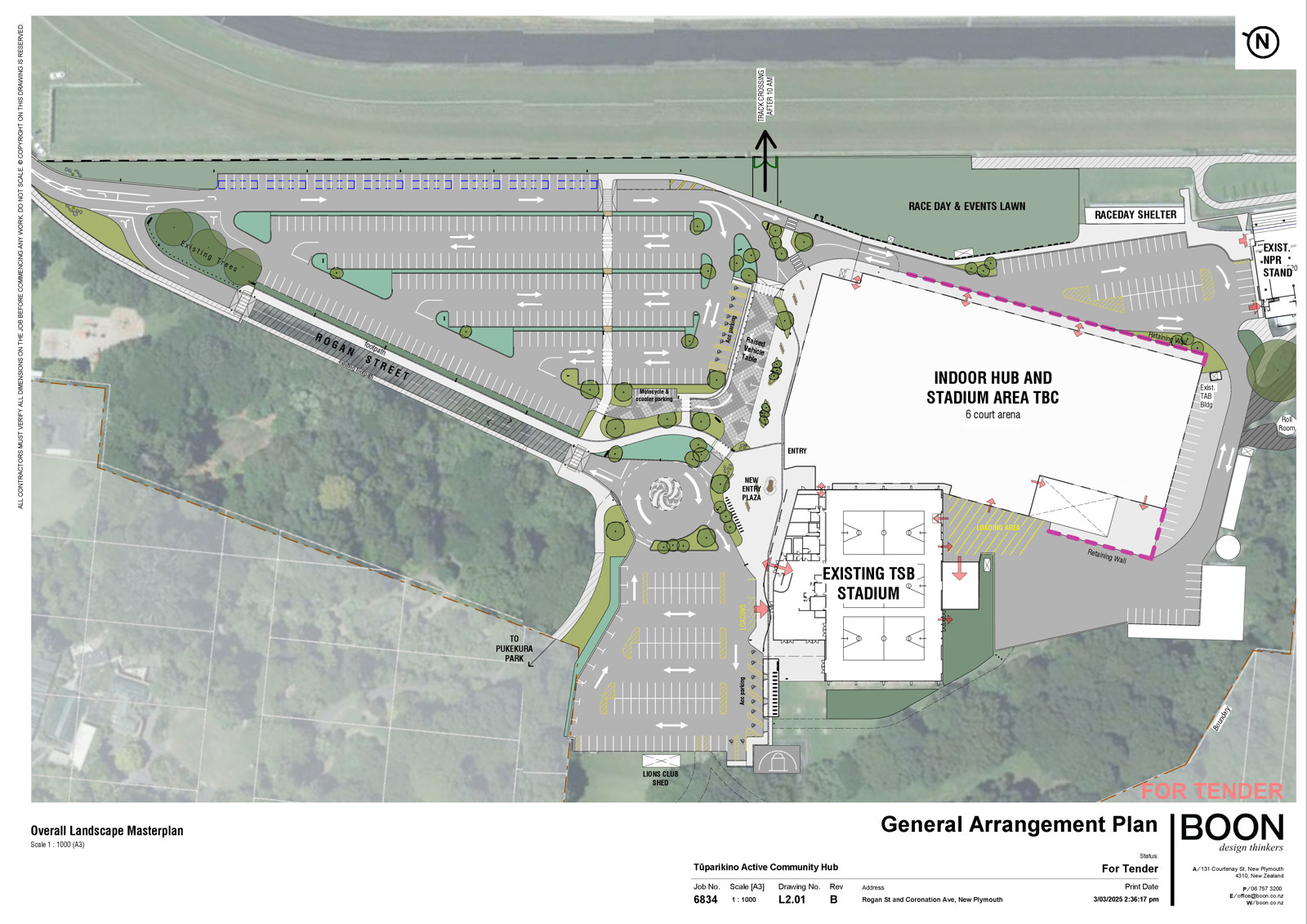

A sustainable hub
Timeline
| Site enabling works  | Underway  | End of 2025  |
| Public Stand demolition  | Due to start March 2025  | May 2025  |
| Civil works phase 1  | Due to start April 2025 | Mid 2026 |
| Civil works phase 2 | Due to start late 2026 | Mid 2027 |
| New Indoor Stadium | Due to start early 2026 | Early 2028 |
27 March 2025: Demolition of stand signals progress for Tūparikino Active Community Hub
